Friday 27 January 2012

Bricks


Bricking has started.  They've done nearly 2 metres high, most of the way around the house.
They've also put the gas and water rough ins throughout the house.  When we went past on wednesday night, the plumber was still there working at 7pm.  Dedicated!






Saturday 21 January 2012

Windows and doors, all wrapped up

Simonds are wasting no time, forging ahead with adding all windows and doors except for the main entrance and the garage entry.
We are also finally in contact with our site supervisor, and have an onsite meeting organised for Tuesday morning.




Thursday 19 January 2012

Balcony

According to the status on our simonds online portal, our frame is officially complete, and we've moved into the lockup stage.  I took this picture yesterday morning, and for the first time, I actually saw people working on the site.  (Yes, that's right, our house is not being built by magical elves that only come out at night and leave behind nothing but fast food wrappers and gatorade bottles, but actual people!)



Anyway, our balcony framing was being finished off yesterday morning, and there was a pile of packages that looked like windows.

Sunday 15 January 2012

Roof trusses

Friday saw the completion of the frame, with roof trusses installed.  The frame stage goes so quickly - they put it all up in 4 days!  I suspect there's still a few minor details to be fixed up, and a frame inspection to take place.  The only downside on all this progress is that we will have our second stage invoice very soon.
For the non-house-building community, there are 5 stages in the building process, and at the completion of each stage, we receive an invoice for a progress payment towards the contracted price.  The percentages can vary depending on how you negotiate the contract.  For us this is 5% deposit, then 10, 15, 35, 25 at each stage, and the final 10% is paid at handover.
Stage 1 is the base stage, which includes the site cut, installation of power and water to the site, and the slab.
Stage 2 is the frame stage (fairly self explanatory).
The next stage for us is the lockup stage.  This includes the roof tiles, gutters and fascia, insulation wrap, windows and external doors, and the bricking.  From my observation this should take about 6 weeks.
Stage 4 is the fixing stage.  Essentially the outside is all but done, and work starts on the internals.  Pipes and wiring are installed inside the walls and ceiling, kitchen/bathroom/laundry cupboards are put in, plaster is installed, internal doors, skirting and architraves are installed.
Stage 5 is the final stage, so pretty much everything else required to be ready for handover. Painting and tiling are the big things, plus installation of all the finishing details, shower screens, mirrors, door handles, power points and light switches, connection of taps and toilets, driveway paving.

We're hoping to meet the site supervisor this week and get a bit more feedback on how he thinks things will go over the next few weeks.


Friday 13 January 2012

Upstairs, downstairs

Our first floor frames have been added, and I'm now a bit overwhelmed by how big the house looks, particularly from the back.  I also managed to walk around inside, and got a bit snap happy - I'll try to be selective...

Front view

Front right corner

Back right corner

Back left, looking down the side

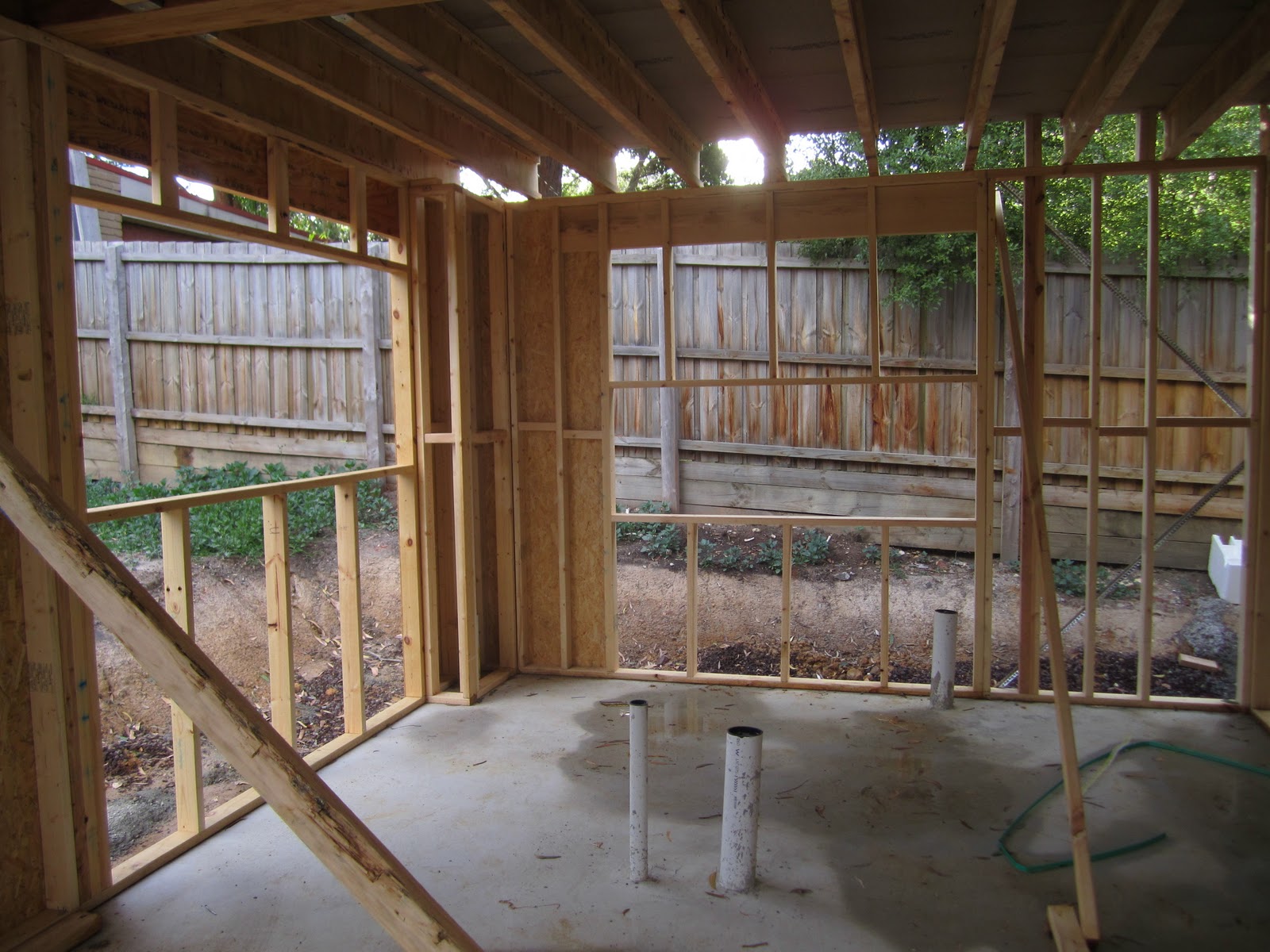

Walk in pantry and fridge space

Kitchen
Main living/dining area, looking back to the front of the house
Where the stairs will be.  Love all that storage space...

Tuesday 10 January 2012

The House Goes 3D

After a two week break over christmas, work began again on site today, with our ground floor frames going up.
